JOBS, FINANCE

The Job Finance Tab

15 November 2026
FinanceJob financeCashflowBudgets

Every job has a Finance tab. Its Overview puts the job's revenue and costs side by side: what the job is worth, what it was budgeted to cost, what it has cost so far and how much the customer has paid.

Who can see this: owners, admins and office staff. Plan: Crew, Business or Pro. On the Free plan the tab is locked behind a Premium Finance Features panel.

Open the job and click Finance. It opens on Overview. The figures cannot be edited there - see Changing a figure below. The rest of the Finance menu is covered in Set Up a Payment Schedule and Raise an Invoice and Record a Payment (Invoicing), VAT and CIS on a Job (Tax Settings) and Labour, Material and Plant Budgets (the budget tabs, Purchase Invoices, Quote Requests and Purchase Orders).

Budgets and actual costs

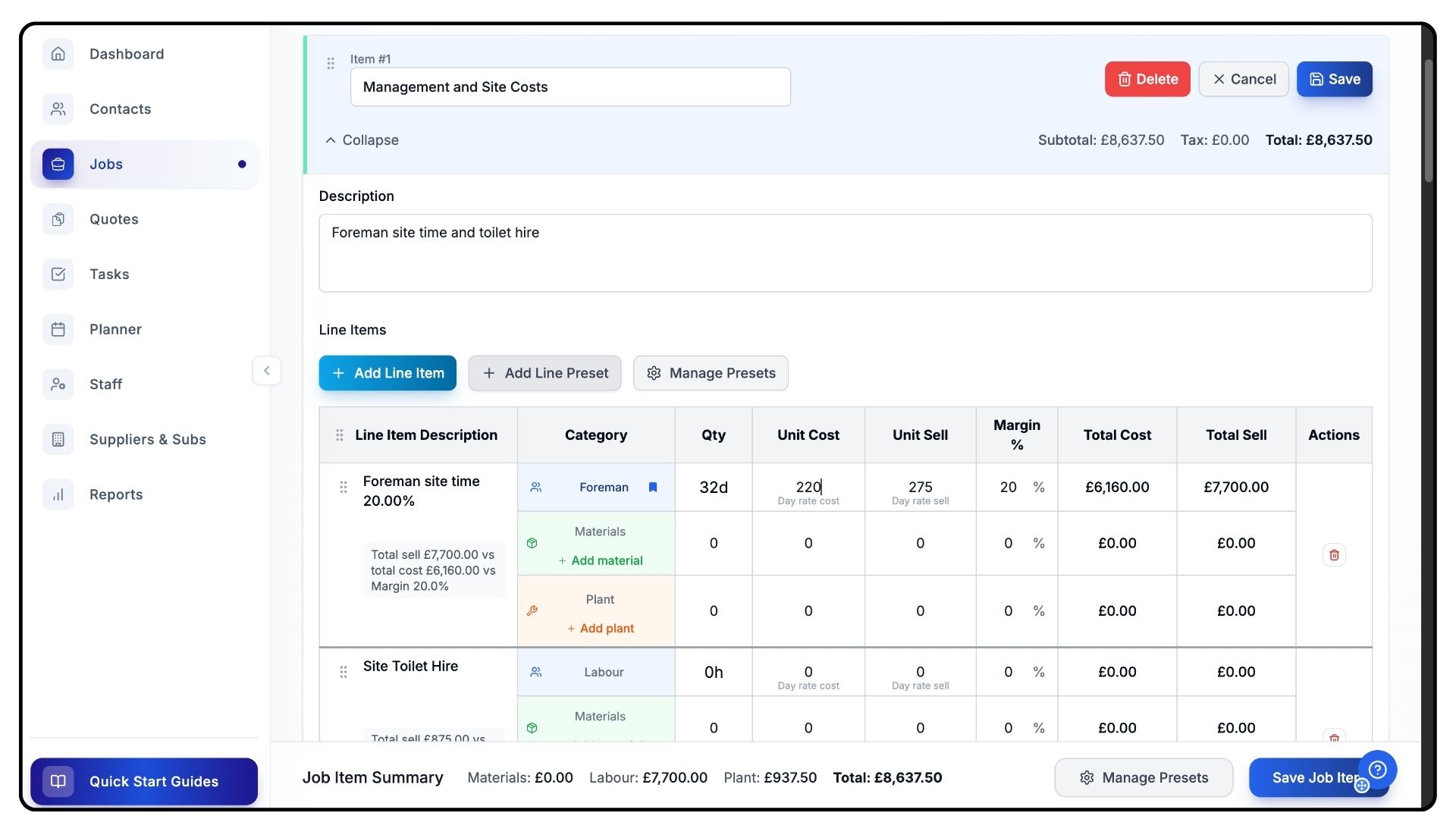

The cost you enter for labour, materials and plant on a line item is a budget: what you expect the work to cost. It is not what you have spent. A line with no cost entered has no budget, rather than a cost of nothing. See Build a Job Up: Job Items and Line Items.

Actual costs come from:

  • Approved purchase invoices filed against the job. A material invoice counts as Material, a plant invoice as Plant, and a subcontractor invoice as Labour. Invoices still waiting for approval are not counted.
  • Logged labour - time your staff have clocked on the job, including travel time and approved timesheet adjustments, costed at each person's pay rate.

All costs on the Overview are shown ex VAT unless they are marked inc VAT.

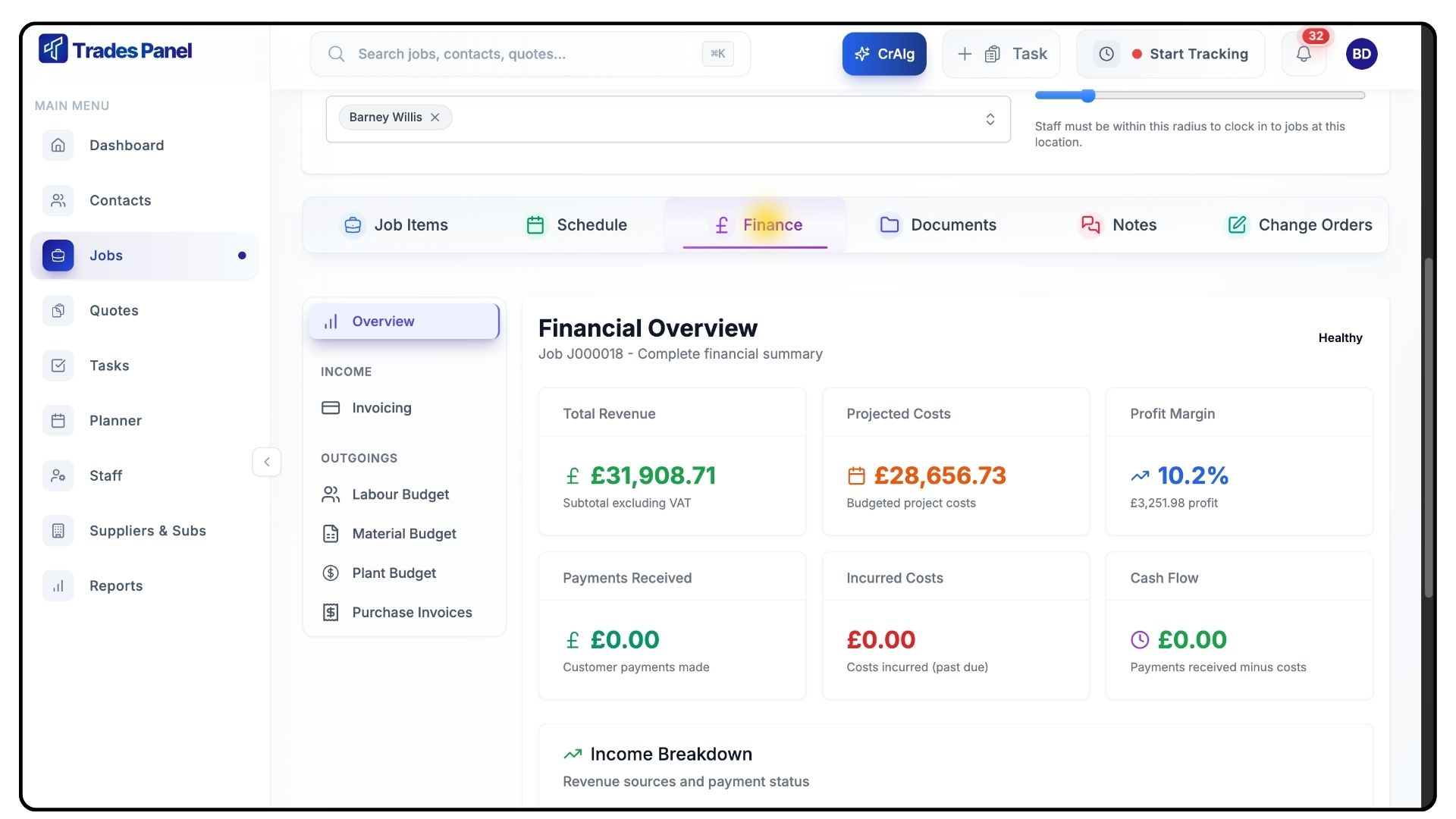

Total Revenue, Projected Costs and Profit Margin

The three headline figures.
The three headline figures.
  • Total Revenue - the job's subtotal excluding VAT.
  • Projected Costs - the labour, material and plant budgets from the job's line items, added together.
  • Profit Margin - Total Revenue less Projected Costs, as a percentage of Total Revenue, with the profit in pounds underneath.

Profit Margin is worked out from the budgets, so it does not change when actual costs come in. Overspending shows in the Expenditure Breakdown below.

The badge beside Financial Overview reads Negative Cash Flow when the job's Net Position is below zero. Otherwise it reads Low Margin under 10%, Healthy from 10% to 25% and High Margin above 25%.

Cashflow Analysis

Cash In, Cash Out and Net Position, above a chart of the same running totals.
Cash In, Cash Out and Net Position, above a chart of the same running totals.

These figures include VAT and count only what has happened up to today.

  • Cash In - payments received from the customer. Payments recorded in Xero against the job's invoices are included.
  • Cash Out - approved purchase invoices due today or earlier, plus logged labour. An invoice with no due date counts from its invoice date.
  • Net Position - Cash In less Cash Out, in green when it is positive and red when it is negative.

The chart plots the three as running totals. Lines are solid up to Today, then dashed for payments still due on the job's payment schedules, invoices not yet due and booked work. Hover over a day to see what happened on it.

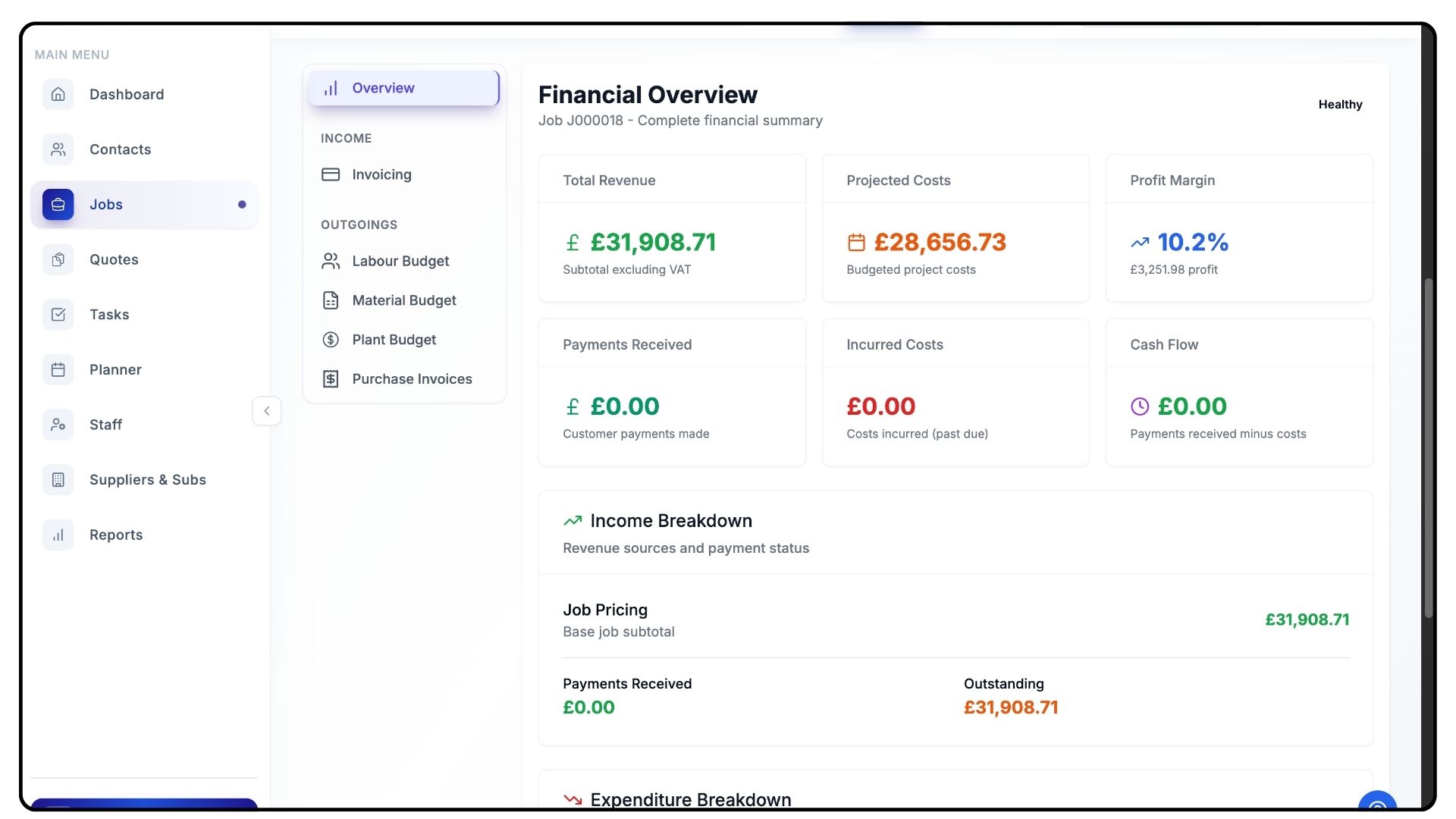

Income Breakdown

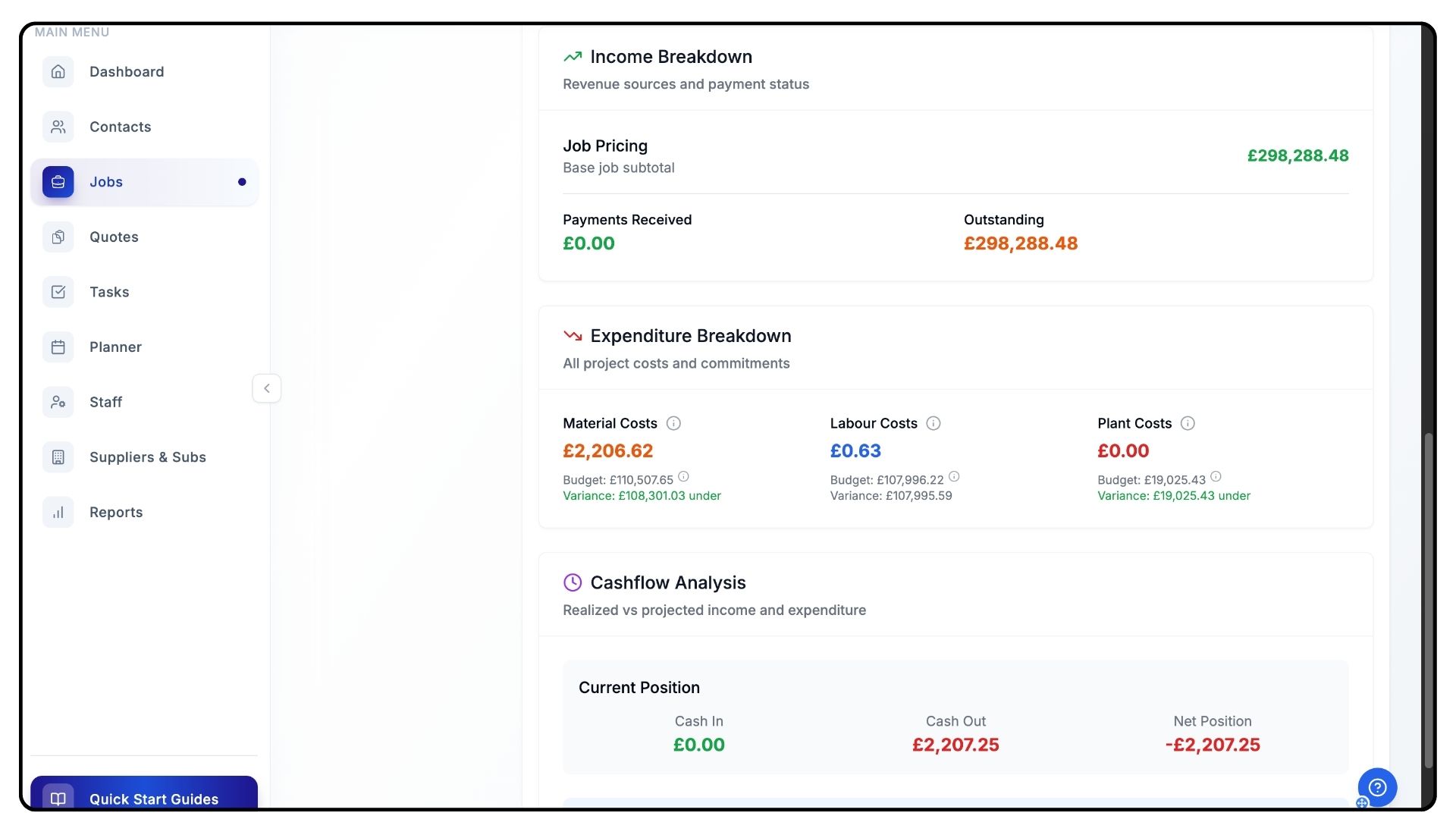

Job Total is the job's price including VAT, with the net and VAT split underneath. It matches the total on the Job Items tab. Payments Received and Outstanding sit below it, and Outstanding turns green once it reaches zero. On a job set to Subcontractor for CIS, each payment is due less its CIS deduction, so Outstanding reaches zero once every payment is paid net of CIS and matches the outstanding balance on the Invoicing tab. See VAT and CIS on a Job.

Expenditure Breakdown

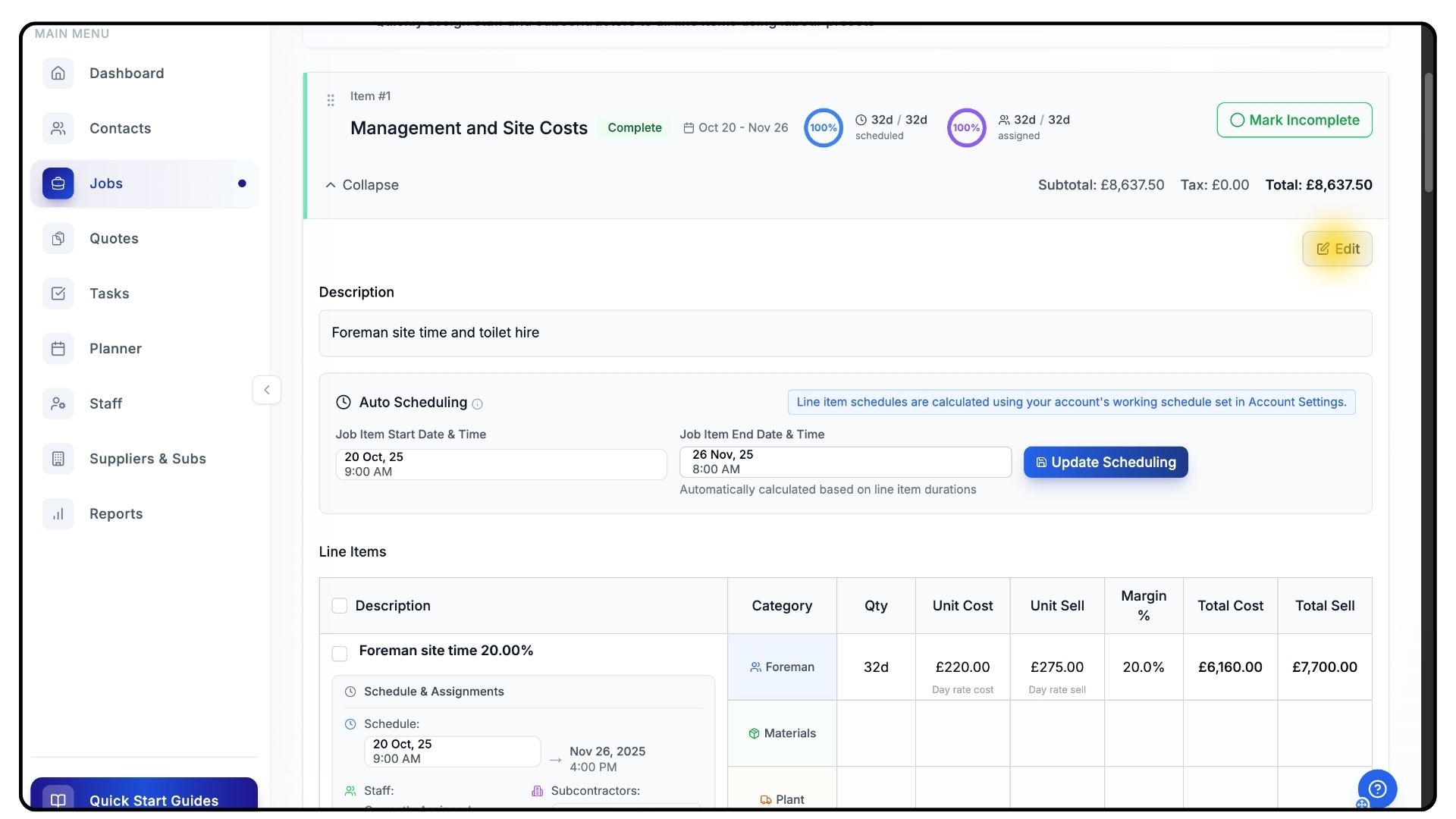

One card each for material, labour and plant, with the budget at the top right and the total committed underneath.
One card each for material, labour and plant, with the budget at the top right and the total committed underneath.

Material Costs, Labour Costs and Plant Costs each have a card showing:

  • Budget, at the top right.
  • The large figure, marked committed - every approved cost of that type, whatever its due date, ex VAT, with the inc VAT amount underneath. For labour it also includes scheduled work.
  • Incurred (past due) - approved invoices due today or earlier, and for labour, logged labour.
  • Upcoming (future due) - approved invoices that are not due yet, and for labour, scheduled work.
  • Variance - the budget against the committed figure, shown as under budget in green or over budget in red.

Total committed adds the three cards together. View breakdown on a card opens that cost type's budget tab.

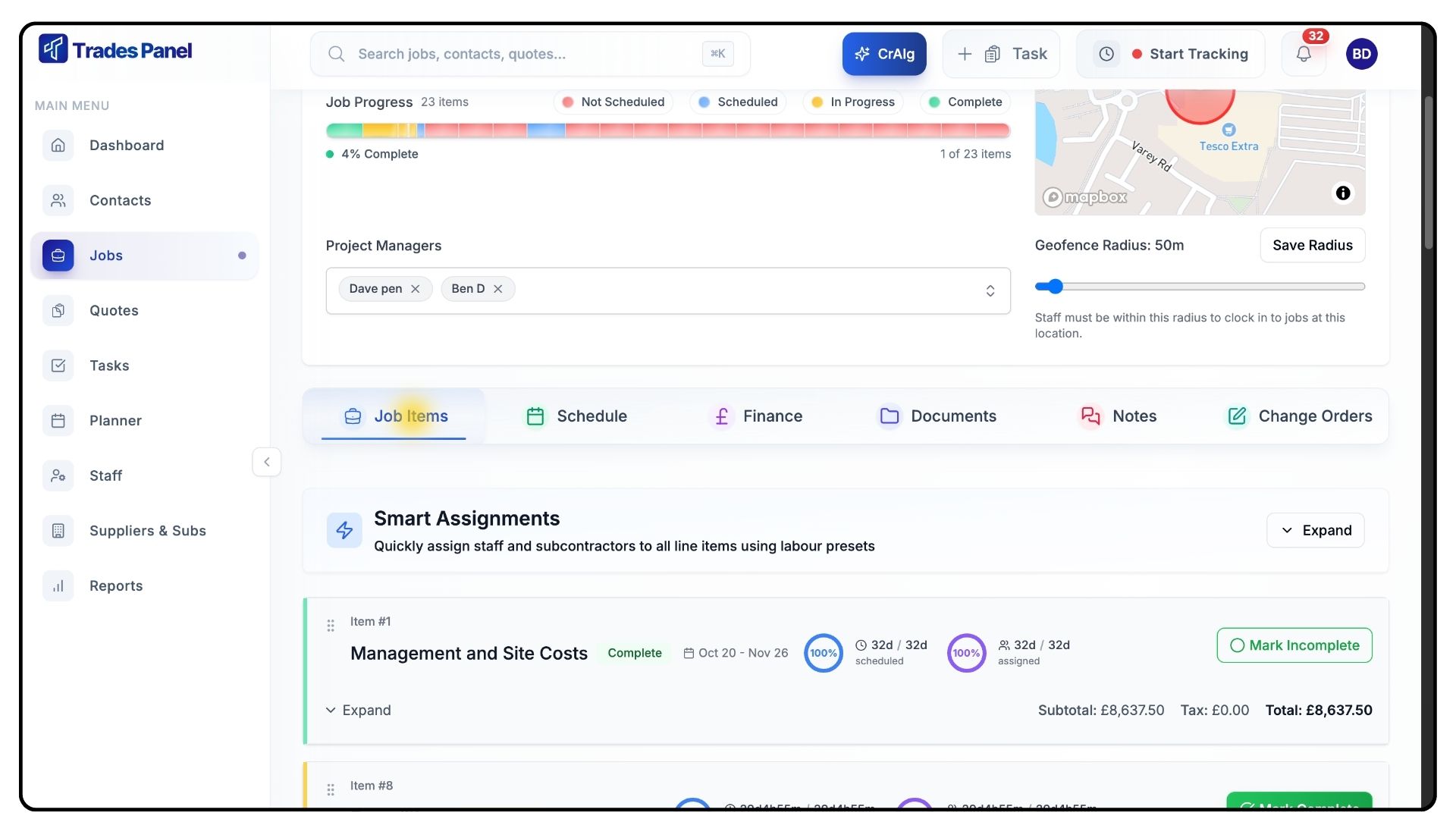

Scheduled work

Click Upcoming on the Labour Costs card to split it into Upcoming invoices (approved subcontractor invoices not yet due) and Scheduled work.

Scheduled work is a forecast of staff booked onto the job for a future date, costed at their pay rates. It is not money owed. When someone starts the work, the booking leaves the forecast and the hours they actually log appear under Incurred once they clock out. A booking that is cancelled, or whose date passes without anyone working it, leaves the forecast with nothing in its place. See Book Staff onto a Job.

If anyone with time or bookings on the job has no pay rate, a red notice above the figures names them, and their labour counts as £0 until a rate is set.

Changing a figure

  • Revenue, Job Total and budgets - edit the job items and line items on the Job Items tab.
  • Material, plant and subcontractor costs - add or approve a purchase invoice against the job, on the Purchase Invoices tab.
  • Logged labour - comes from staff time logs, costed at each person's pay rate. A day rate is converted using your account's working hours.
  • Payments received - record a payment on the Invoicing tab.
